Pace Street Improvements
Project Overview
The Pace Street Improvements project between 9th Avenue and 17th Avenue will rehabilitate and widen the asphalt, make walking and biking easier, and upgrade the street’s drainage.
What’s included:
-
- Buffered bike lanes in both directions for more space and safety
- Two rapid-flashing crosswalk beacons (RRFBs) to help people cross more safely
- Stormwater drainage upgrades including new curb and gutter on the west side of Pace Street
- Rough and Ready Greenway Trail Improvements between Pace Street (north of 9th Ave.) and Mountain View Ave.
Project Status
Updated: November 12, 2026
Construction started May 4 and is expected to be completed in late 2026.
Paving Operations:
-
- Nov. 16-19: Paving on Pace St. between Mountain View Ave. and 17th Ave.
- One lane will be open in both directions on Pace St. However, drivers should expect major delays while paving equipment passes through.
- The intersections at Mountain View Ave. and 17th Ave. will be open to through traffic and all turns onto Pace St. will be available.
Access During Paving:
-
- Fox Creek Village/King Soopers: At least one driveway entrance from Pace Street will remain open throughout paving operations. Access from 17th Avenue will also remain open.
- Fox Creek Marketplace/VASA Fitness: The Pace Street entrance will be closed for approximately two to three hours while crews pave in front of the driveway. Drivers should use the entrance from 17th Avenue during the temporary closure.
- Red Oak Drive: The east and west entrances to Red Oak Drive from Pace Street will be temporarily closed at different times as paving progresses. Each closure is expected to last approximately two to three hours. Residents west of Pace Street can access their neighborhood from 17th Avenue. Residents east of Pace Street will use 17th Avenue or Mountain View Avenue.
- Skyline High School Athletic Field: The parking lot entrance from Pace Street will be temporarily closed during paving. Crews expect to reopen the west side of Red Oak Drive before closing the athletic field entrance. Visitors can park along Red Oak Drive during the closure.
- Pedestrian Access: Pedestrians should cross Pace Street only at the signalized intersections at Mountain View Avenue or 17th Avenue. The pedestrian-activated flashing crossing lights at Red Oak Drive will be turned off until paving is complete.
Construction hours: Monday – Friday from 7 am – 6 pm. There may be times when work is required on the weekends due to weather and other factors.
Rough and Ready Greenway Trail:
-
- The Rough and Ready Greenway Trail has been completed and is currently open.
Goals & Planned Improvements
This project aims to fix the roadway, widen the street and improve the drainage system along Pace Street from 9th Avenue to 17th Avenue. These upgrades will help traffic move more smoothly and make the street safer for everyone. Completing this rehabilitation work now costs less than waiting until the road becomes more damaged and requires reconstruction.
Project Schedule
Finalized Design – December 2025
Bid Advertisement for Contractor – February 2026
Construction Awarded to Contractor – March 2026
Construction Start – May 2026
Anticipated Construction Period – 8 Months

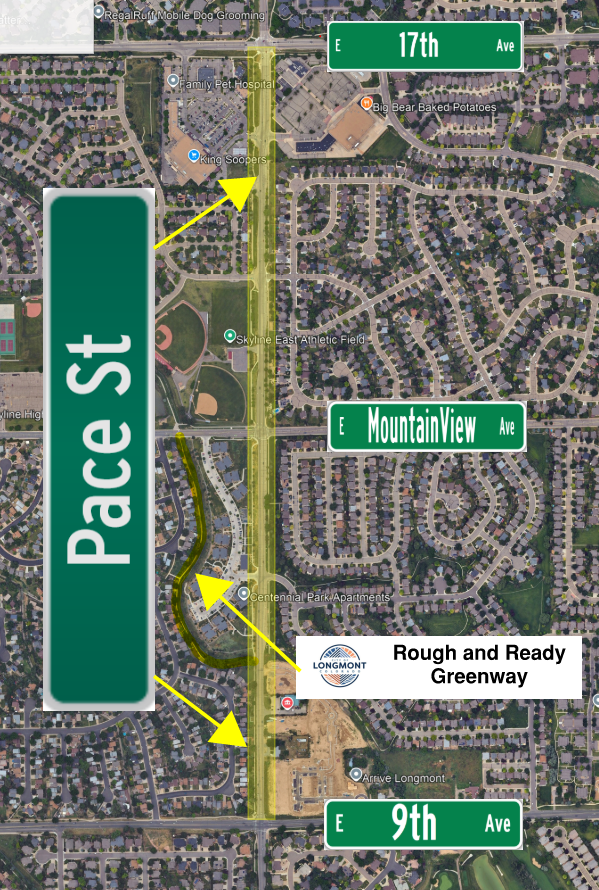

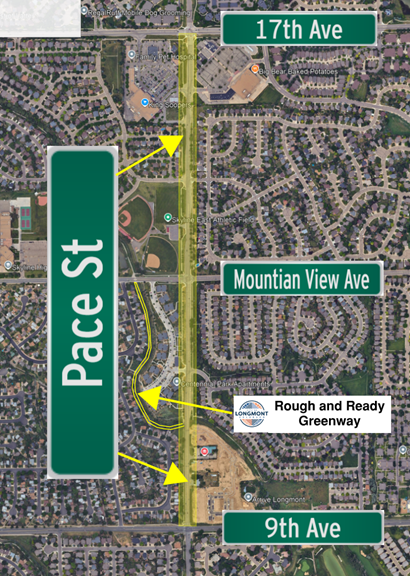

Project Map
The following map illustrates the project corridor and area of focus:

The Street Fund Sales and Use Tax provides funding for a variety of City transportation services, programs, and improvements. The Street Fund Sales and Use tax is 3/4 of a cent, or less than one cent on a one-dollar purchase.
The City of Longmont’s Storm Drainage Fund is used for the maintenance, operation, and capital improvements of the city’s storm drainage system. It is funded by monthly user fees charged to residential and non-residential customers, as well as a 2022 storm drainage bond approved by voters.
This fund is used to pay for a portion of the capital costs for arterial street and intersection improvements needed due to new development in the city. It is established to ensure that new growth contributes to the infrastructure required to handle its impact on the transportation system. This fund receives revenue from payments of the Transportation Impact Fee on new construction.
Yes, the Current posted speed limit on Pace Street is 45 MPH and it will be reduced to 35 MPH.
No, trees will not be removed for the widening effort along Pace Street.
No, southbound and northbound traffic will be maintained with lane shifts. There may be detours set up for pedestrian and bicycle traffic as the sidewalks and curb ramps are under construction.
